Handle weather delays on a concrete pour by building a weather clause into every quote, checking the Bureau of Meteorology forecast 48 hours before the scheduled pour, and having a documented re-scheduling process that captures the cost of standby plant, re-ordered concrete and crew downtime. The biggest margin leak is not the weather itself but the absence of a written variation process when the delay hits.
Updated 06/10/2026
Every Australian concreter knows the feeling: the agitator is booked, the crew is confirmed, and the BOM radar turns green overnight. What separates the operators who absorb the hit from the ones who protect their margin is a written process, not a bigger buffer in the quote. This guide walks through the contract clauses, the go/no-go decision, the re-scheduling steps and the cost recovery method that keep a weather delay from becoming a loss.
Quick answer
Handle weather delays on a concrete pour by building a weather clause into every quote, checking the Bureau of Meteorology forecast two days before the scheduled pour, and having a documented re-scheduling process that captures the cost of standby plant, re-ordered concrete and crew downtime. The biggest margin leak is not the weather itself but the absence of a written variation process when the delay hits.
Key takeaways
- A weather clause in your quote is the single cheapest protection: it shifts re-scheduling cost to a documented variation instead of an argument.
- Check the BOM forecast 48 hours and again 12 hours before a pour, and set a go/no-go threshold (generally above 60 per cent chance of rain or winds above 40 km/h).
- Concrete that absorbs unplanned rainwater can lose up to 20 per cent of its specified compressive strength, turning a weather gamble into a defect liability.
- Standing time for a concrete pump typically costs $150 to $300 per hour, so a late call-off burns money faster than an early one.
- Document every weather decision in writing, even a text message, to protect yourself if a client disputes the delay or the variation.
Why does weather matter so much for concrete?
Concrete is a chemical reaction, not just a material. The water-cement ratio controls the final strength, and anything that changes that ratio after batching, whether rain adding water to the surface or extreme heat evaporating it, compromises the result.
- Rain during placement. Uncontrolled addition of water to the concrete mix increases the water-cement ratio and can reduce compressive strength by up to 20 per cent (Cement Concrete and Aggregates Australia). Surface washing also creates a weak top layer prone to dusting and scaling.
- Cold weather. Concrete placed at temperatures below 5 degrees Celsius can take up to twice as long to reach design strength (CCAA). In southern states through winter, an early-morning pour can start below that threshold.
- Extreme heat. Ambient temperatures above 35 degrees Celsius accelerate setting, making it harder to finish the surface before it crusts, and increase plastic shrinkage cracking. Most capital-city summers see stretches above that mark.
- High wind. Winds above 40 km/h strip moisture from the surface faster than a finisher can work it, producing the same cracking risk as heat.
The common thread is that weather does not just delay the pour, it can turn a correctly specified mix into a defect. That is why a go/no-go decision is a quality-control step, not a scheduling inconvenience.

What should a weather clause in your quote include?
A weather clause is the single cheapest protection a concreter can add to a quote. Without one, the ACCC position is clear: A quote is a fixed price. If you give a quote, you can't charge more than the quoted amount.
That means every dollar of re-scheduling cost comes off your margin unless the quote explicitly allows for it.
A practical weather clause covers four things:
- The trigger. Name the specific conditions that activate the clause. For example: BOM forecast probability of rain above 60 per cent during the pour window, ambient temperature below 5 degrees Celsius or above 35 degrees Celsius, or sustained wind above 40 km/h.
- The notice period. State how much notice you will give the client before postponing. 24 hours is a reasonable minimum; it gives the batch plant time to reschedule the load.
- The variation rate. List the costs the client bears on a weather postponement: concrete re-order fee (if the batch plant charges one), pump standby or cancellation fee, and crew standby time at an hourly rate.
- The re-scheduling commitment. Commit to rebooking within a stated window (for example, the next available day that meets the weather criteria within 7 business days) so the client knows the delay is bounded.
Keep the language plain. A clause that a homeowner cannot understand is a clause they will dispute. For guidance on quoting in general, see our guide to pricing a concrete slab.
How do I make the go/no-go call?
The decision to pour or postpone should be a documented two-step check, not a gut feel on the morning.
- 48-hour check. Pull the BOM forecast for the site suburb 48 hours before the pour. If rain probability exceeds your trigger threshold or temperatures sit outside the safe range, notify the client and the batch plant that the pour is conditional.
- 12-hour check. Twelve hours before the pour, recheck the BOM radar and the hourly forecast. If conditions have improved, confirm the pour. If they have not, issue the postponement notice in writing (a text message is fine, so long as you save it).
Why two checkpoints? The batch plant typically needs 24 hours to cancel without a fee, and the pump hire needs a similar window. A same-morning call-off after the truck has loaded is the most expensive outcome for everyone.

What does a weather delay actually cost?
The direct costs add up faster than most concreters expect, especially on a residential job where specialty trade contractors typically operate on gross margins of 15 to 25 per cent (The Access Group, AU construction margins). A single unplanned delay can eat most of that margin.
| Delay cost item | Estimate (AUD) | Notes |
|---|---|---|
| Concrete re-order or short-load fee | $200 to $500 | Varies by supplier and load size |
| Pump standby or cancellation | $150 to $300 per hour | Most charge from arrival |
| Crew standby (2 to 3 workers) | $300 to $600 per half day | Includes super at 12 per cent |
| Site re-preparation (re-compact, re-clean formwork) | $200 to $400 | If rain has saturated the base |
| Total single-delay estimate | $850 to $1,800 |
On a residential slab job in the $3,000 to $25,000 range, a delay costing $1,000 or more without a variation clause wipes the margin on the smaller jobs entirely. The weather clause exists to make these costs visible and recoverable, not to penalise the client.
How do I protect the slab if rain arrives mid-pour?
Sometimes the forecast is wrong and rain arrives after the truck has tipped. The response depends on how far along the pour is.

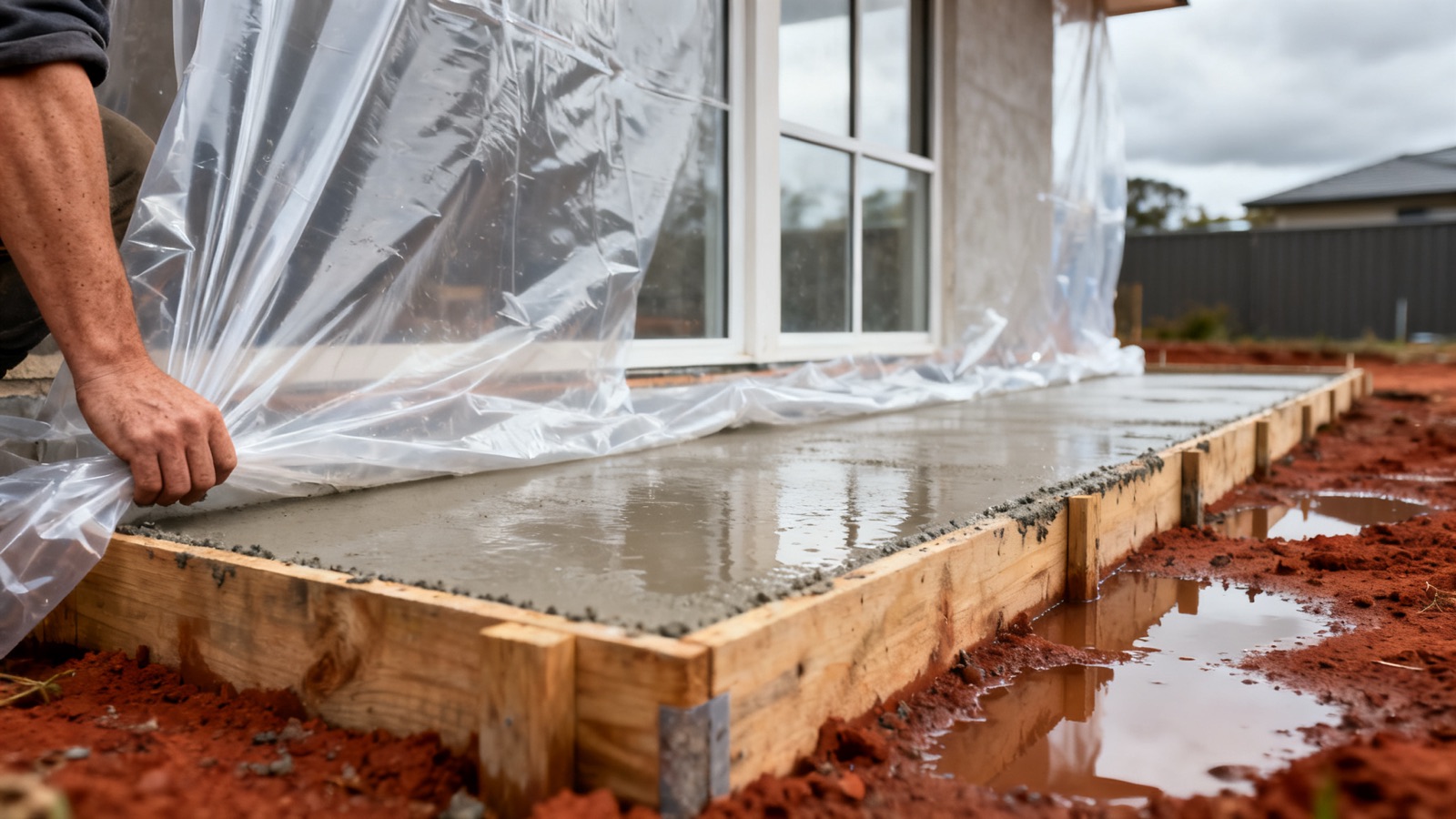

- Concrete still being placed. Stop tipping, cover the unfinished area with plastic sheeting immediately, and assess whether the rain is passing or setting in. If the slab is less than half poured, it may be better to stop and pour the remainder on a dry day (with a construction joint) than to risk the full area.
- Concrete placed but not finished. Cover the surface with plastic sheeting, leaving enough slack so the sheet does not imprint on the wet concrete. Wait for the rain to pass, then remove the sheeting and finish. Minor surface water can be floated off with a bull float, but never work excess water back into the surface.
- Concrete already being finished. Cover immediately. If the surface has been washed before it has set enough to resist, the top layer may need to be re-floated or, in the worst case, ground back once cured. Document the condition with time-stamped photographs.
In every scenario, photograph the conditions and the actions taken. These records protect you if the client raises a defect claim weeks later, and they support a variation claim if the clause is active.

What are the contract and compliance angles?
Weather delays sit at the intersection of contract law and building standards. Getting the paperwork right matters as much as getting the concrete right.
- Quotes vs estimates under ACL. Under Australian Consumer Law, a quote is a fixed price. If your document says "quote" and does not include a weather clause, you cannot charge more when a delay hits. If you want flexibility, either include the clause or label the document an estimate with a clear explanation of what may vary.
- Written variations. Every weather delay that triggers additional cost should be confirmed in writing before the cost is incurred. A text message the client acknowledges is sufficient, but a signed variation form is stronger. This protects both parties and is standard practice under state building-contract legislation.
- Defect liability. If you pour into adverse conditions and the slab develops surface defects, the statutory warranty period applies. In New South Wales, structural defects carry a six-year warranty under the Home Building Act 1989, and non-structural defects carry two years. A documented weather decision that led to postponement is evidence of due diligence; a pour forced through rain is evidence of the opposite.
- WHS obligations. Wet, cold or extremely hot conditions carry their own workplace health and safety risks: slippery formwork, heat stress, reduced visibility. A postponement for safety reasons is never a cost to justify, it is a legal obligation.
For concreters managing no-shows and reschedules more broadly, the same written-variation discipline applies to any schedule change, not just weather.
How do I keep the schedule moving through a wet week?
A single delay is manageable. A wet week that pushes three or four jobs back is where the real damage happens, because every postponed pour stacks onto the same recovery window and the crew sits idle.
- Stagger your bookings. Do not book consecutive pours on consecutive days during a season with volatile weather (October to March in most of eastern Australia). Leave a buffer day between pours so a single postponement does not cascade.
- Fill delay days with prep work. Use postponed pour days for formwork, reinforcement, site preparation or quoting. Crew time spent on productive non-pour tasks is better than standby.
- Batch your smaller jobs. If you have two or three small pads (driveways, paths, shed slabs) that can share a truck load, schedule them on the same day so a cancellation affects one booking, not three.
- Communicate early with the pump hire and batch plant. Suppliers who get consistent, honest notice when a pour is conditional are more likely to accommodate a late reschedule without penalty. The relationship matters.
A job management app that tracks weather-affected jobs alongside your schedule makes the recovery visible. If you are still tracking jobs on paper or a whiteboard, see our guide to job management software for tradies for options that handle rescheduling.
What can a discovery call uncover about your weather-delay process?
Most concreters we speak with do not have a weather clause in their quote template and have never costed a delay. In a 15-minute discovery call we look at the quote template, the scheduling method and the variation process to see where weather-related margin is leaking. If the clause is missing, it is usually the fastest fix in the audit.
Book a free 15-minute discovery call to see where your quoting and scheduling process sits: book here.
Common questions
Can I pour concrete in the rain?
Light drizzle on a slab that has already started to set is manageable with plastic sheeting, but pouring into active rain risks washing cement paste from the surface and weakening the top layer. If the BOM forecast shows more than 60 per cent chance of rain during the pour window, postpone.
Who pays for a weather delay on a residential concrete job?
It depends on your contract. Under Australian Consumer Law, a quote is a fixed price (ACCC guidance), so without a weather clause the concreter absorbs the re-scheduling cost. A written weather-delay clause shifts standby, re-order and crew costs to a documented variation.
How hot is too hot to pour concrete in Australia?
Ambient temperatures above 35 degrees Celsius accelerate setting and increase cracking risk. The Cement Concrete and Aggregates Australia (CCAA) recommends planning hot-weather pours for early morning, using retarders, and keeping all surfaces damp before placement.
What should a weather clause in a concreting quote say?
State the trigger (for example, BOM forecast above 60 per cent rain or temperature below 5 degrees or above 35 degrees), the notice period you will give the client (24 hours minimum), and the variation rate for standby plant, concrete re-order and crew time. Keep the clause in plain language.
Do I need to cover fresh concrete after pouring?
Yes. Covering a slab with plastic sheeting or applying a curing compound within 30 to 60 minutes of finishing protects against moisture loss in heat and rain damage in wet weather. Curing concrete for at least seven days is standard Australian practice for residential slabs (AS 3600).
